What happened
PJM Interconnection, the largest U.S. grid operator serving roughly 67 million people across 13 states from Illinois to Virginia, cleared its capacity auction for 2028–29 at $325 per megawatt-day—the maximum price cap—while supply fell about 6.8 gigawatts short of grid reliability needs. This marks the third consecutive auction hitting the price ceiling.
Why it matters
Data centers driving AI buildout account for roughly $6.3 billion of the $16.4 billion in total capacity charges from this auction, yet the cost of building new power plants to serve that demand is spread across all ratepayers rather than billed directly to the tech companies. Moody's Ratings warned that PJM's rules lack mechanisms to ensure hyperscalers pay for new generation, and Reuters reported households and businesses in PJM territory could face rate hikes of up to 60% over the next five years.
What to watch
PJM is requesting emergency permission from the Federal Energy Regulatory Commission to hold a "backstop" capacity auction in September, signaling the normal market cannot produce enough new power fast enough. Some analysts propose requiring data center operators to sign long-term contracts for new generation, though adoption remains uneven across markets.
Ask the AI about this article →
Summaries like this, in your inbox every morning.

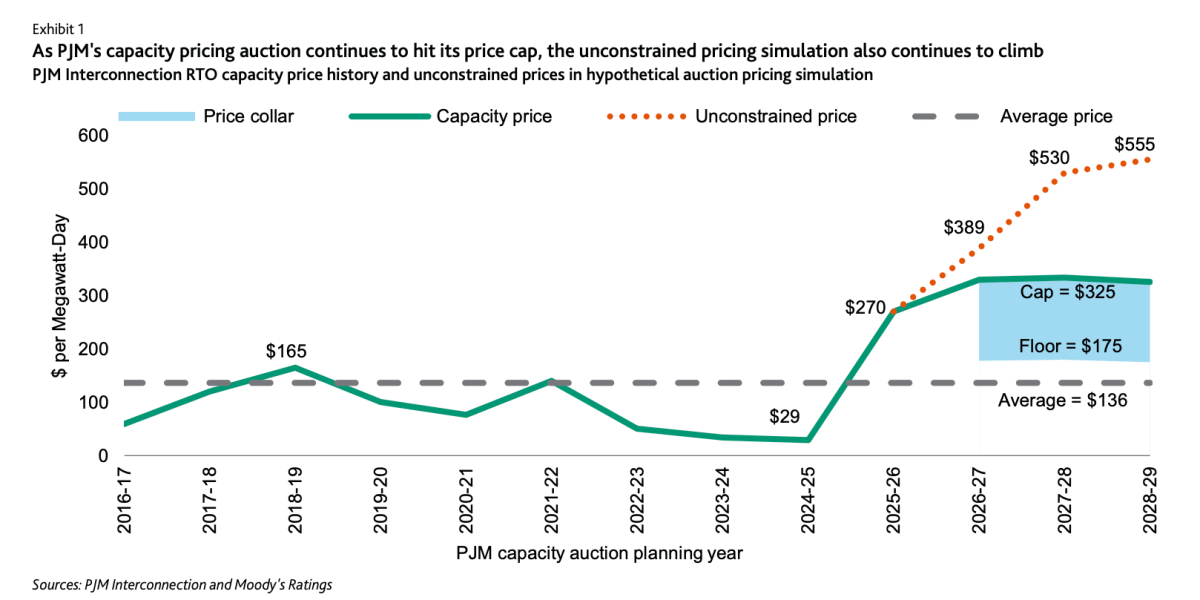

The AI infrastructure boom is colliding with electricity supply constraints in ways that traditional utility cost-sharing rules were never designed to handle. PJM's three consecutive auctions hitting the maximum price cap of $325 per megawatt-day—with only 525 megawatts of new generation capacity clearing, roughly half of what cleared six months earlier—reveal a fundamental mismatch: demand from data centers is growing faster than the grid can add supply. Moody's Ratings, which evaluates risk for bond investors, stepped into typically-neutral territory to flag that PJM's regulatory framework differs from other U.S. power markets by failing to require new large-load customers to sign direct supply contracts. Instead, the cost burden spreads across all ratepayers, creating both fairness concerns and financial pressure on utilities to raise residential rates.
The numbers underscore the scale of the problem. Data centers account for roughly $6.3 billion of the July auction's $16.4 billion in capacity charges—and $29.4 billion cumulatively over four auctions. Without PJM's price cap, simulation shows the unconstrained capacity price would have reached $554.72 per megawatt-day regionally and $776.69 per megawatt-day in the Chicago-area ComEd zone, illustrating how tight the supply-demand balance has become. Reuters reports households and businesses could face rate hikes of up to 60% over five years. These rising bills reflect both direct cost-shifting and simple market scarcity: supply has not kept pace with demand, so capacity prices climb. PJM's request for an emergency "backstop" auction in September is unusual—it signals the ordinary market mechanism cannot move fast enough. Some analysts propose long-term contracts binding hyperscalers to new generation costs, mirroring rules in other markets, though critics note such contracts may not close the supply gap quickly enough and risk broader market distortion.
